About the Project
The Naples Beach Restoration & Water Quality Improvements Project, also known as the Naples Beach Stormwater Outfall Project is underway. The project will significantly enhance water quality through a state-of-the-art stormwater treatment train, improve flood protection, reduce beach erosion, safeguard environmental species, and remove unsightly stormwater outfall pipes from Naples’ beautiful beaches. Additionally, it will bolster the City’s resiliency to climate change and protect our coastal ecosystem. The new stormwater system will improve water quality that exceeds the State’s minimum standards, provide flood protection, and increase the City’s resiliency to the residents within the work area of Gulf Shore Boulevard.
PUBLIC MEETING
The City held a public meeting on Tuesday, January 21, 2025, from 4:30 p.m. to 6:30 p.m. at Grace Lutheran Church.
The public meeting was an open house format.

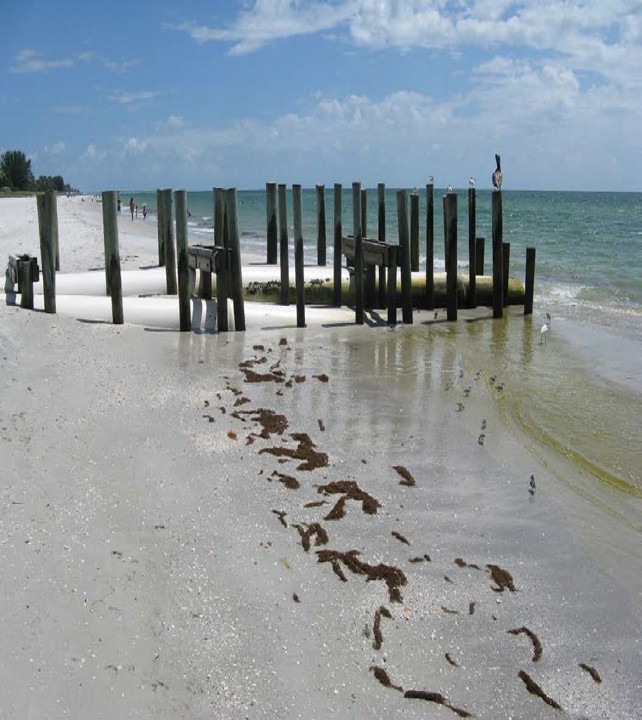

Existing stormwater outfall pipes.
Outfall Pipe Removal

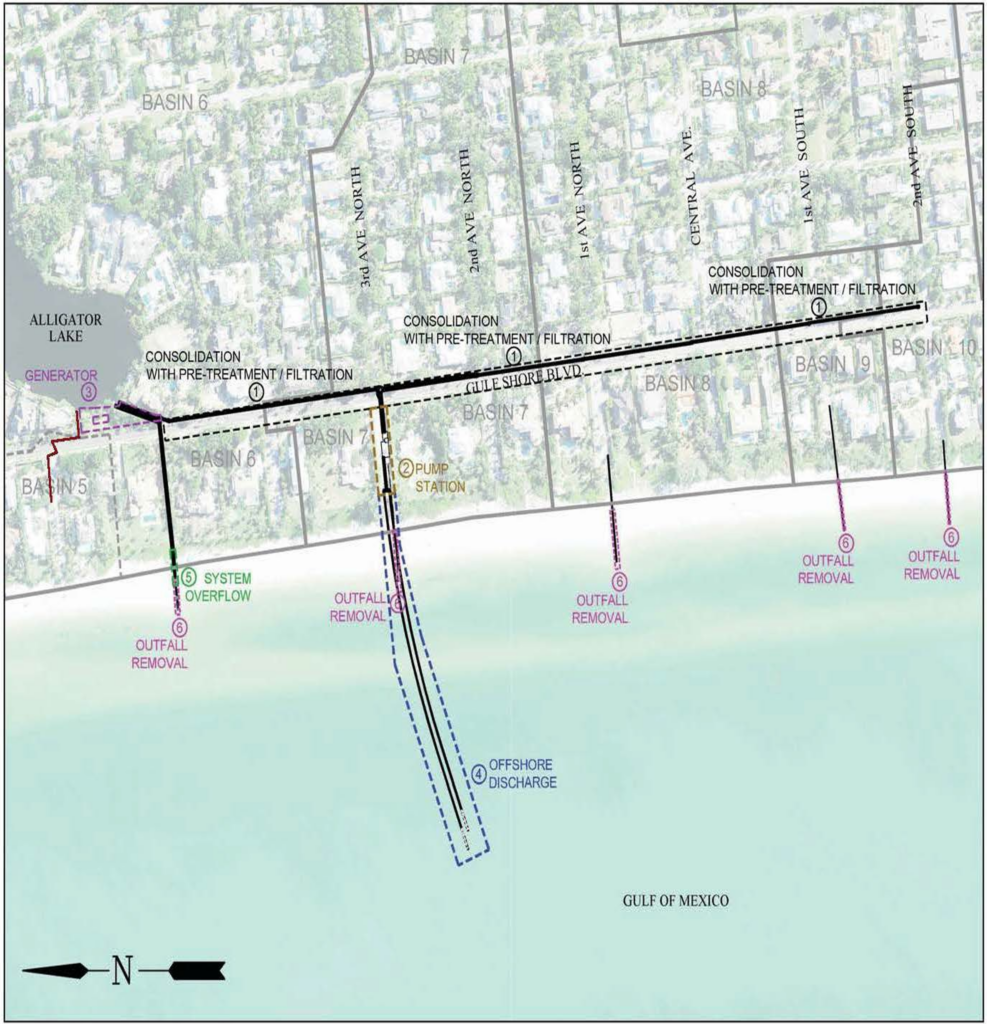

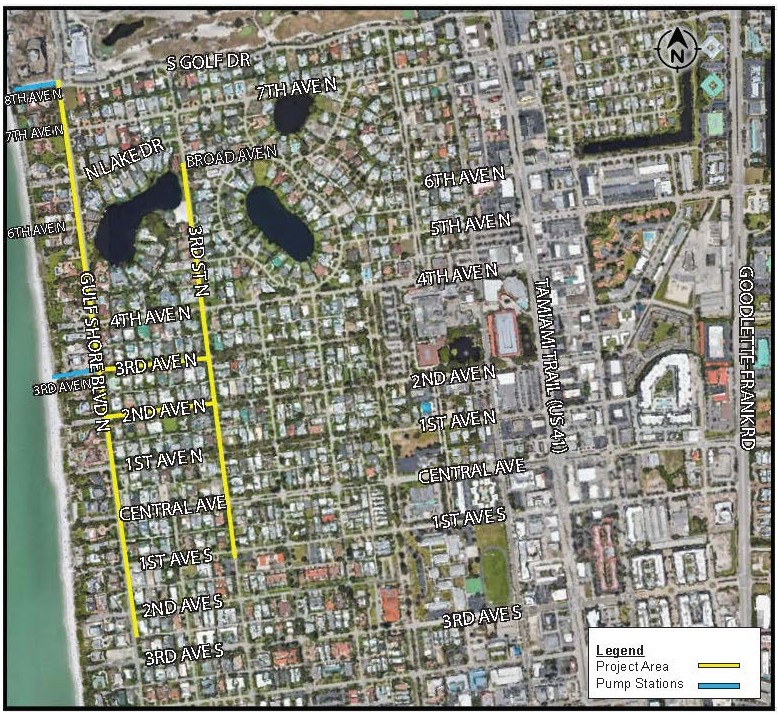

The Naples Beach Stormwater Outfall Project is removing all eight (8) city stormwater outfall pipes from the Naples beaches that currently discharge stormwater into the Gulf of Mexico as directed by the Florida Department of Environmental Protection (FDEP). These improvements are designed to increase the level of service from a 5-year storm event to a 25-year storm event. The project area consists of the Gulf Shore Boulevard (GSB) right-of-way (ROW) between Oleander Drive and just south of 2nd Avenue South along Gulf Shore Boulevard.
The Naples Beach Stormwater Outfall Project cost is $86 million. The State of Florida is providing $40 million for this project through Legislative Appropriations.
PUBLIC MEETING
The City held a public meeting on Tuesday, January 21, 2025, from 4:30 p.m. to 6:30 p.m. at Grace Lutheran Church.
The public meeting was an open house format.
CURRENT CONSTRUCTION ACTIVITIES
Construction has entered the project’s final roadway, drainage, and watermain phase, with major utility work between 4th Avenue North and 1st Avenue North now substantially complete.
Final Roadway, Drainage, and Watermain Phase

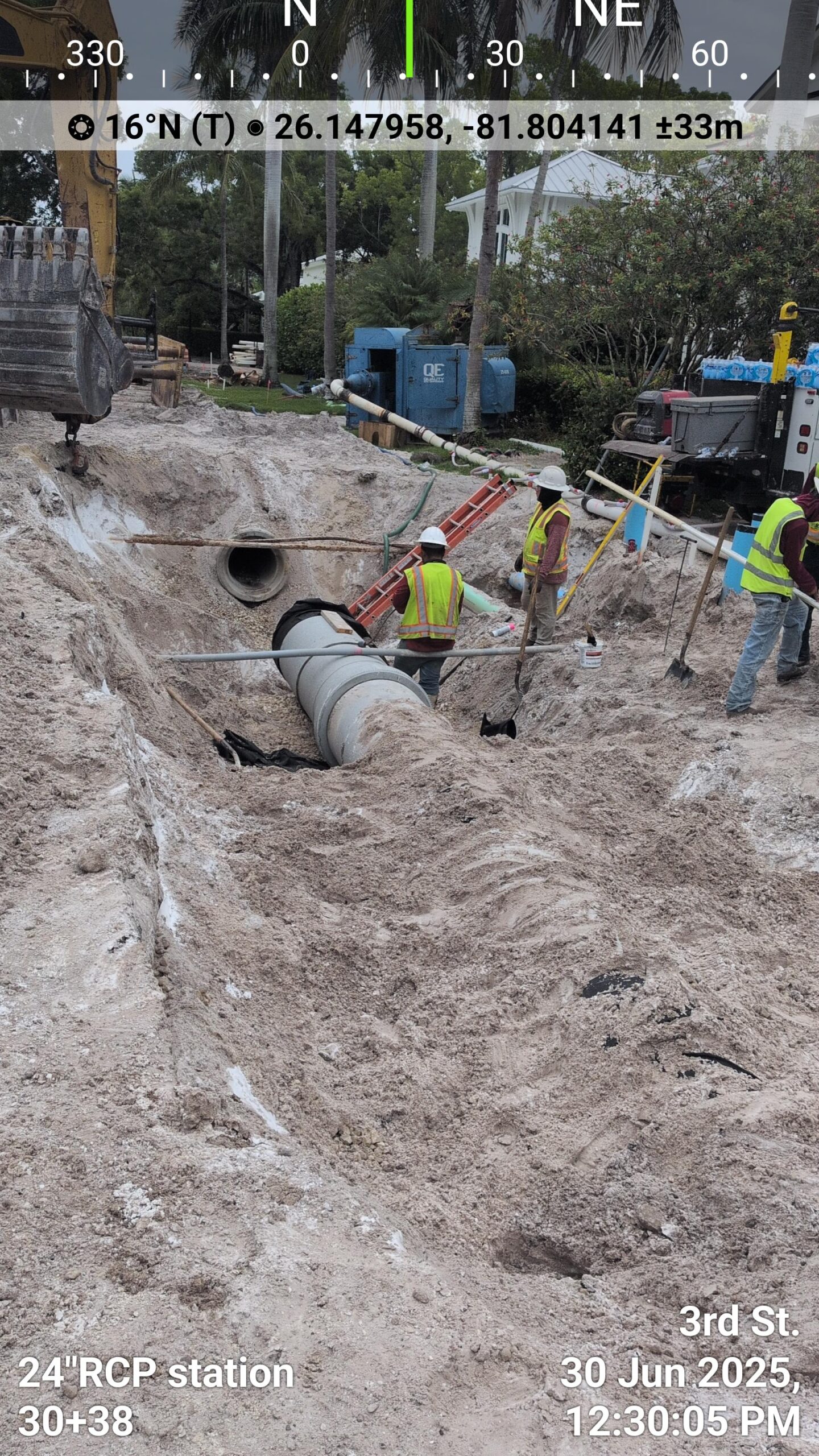

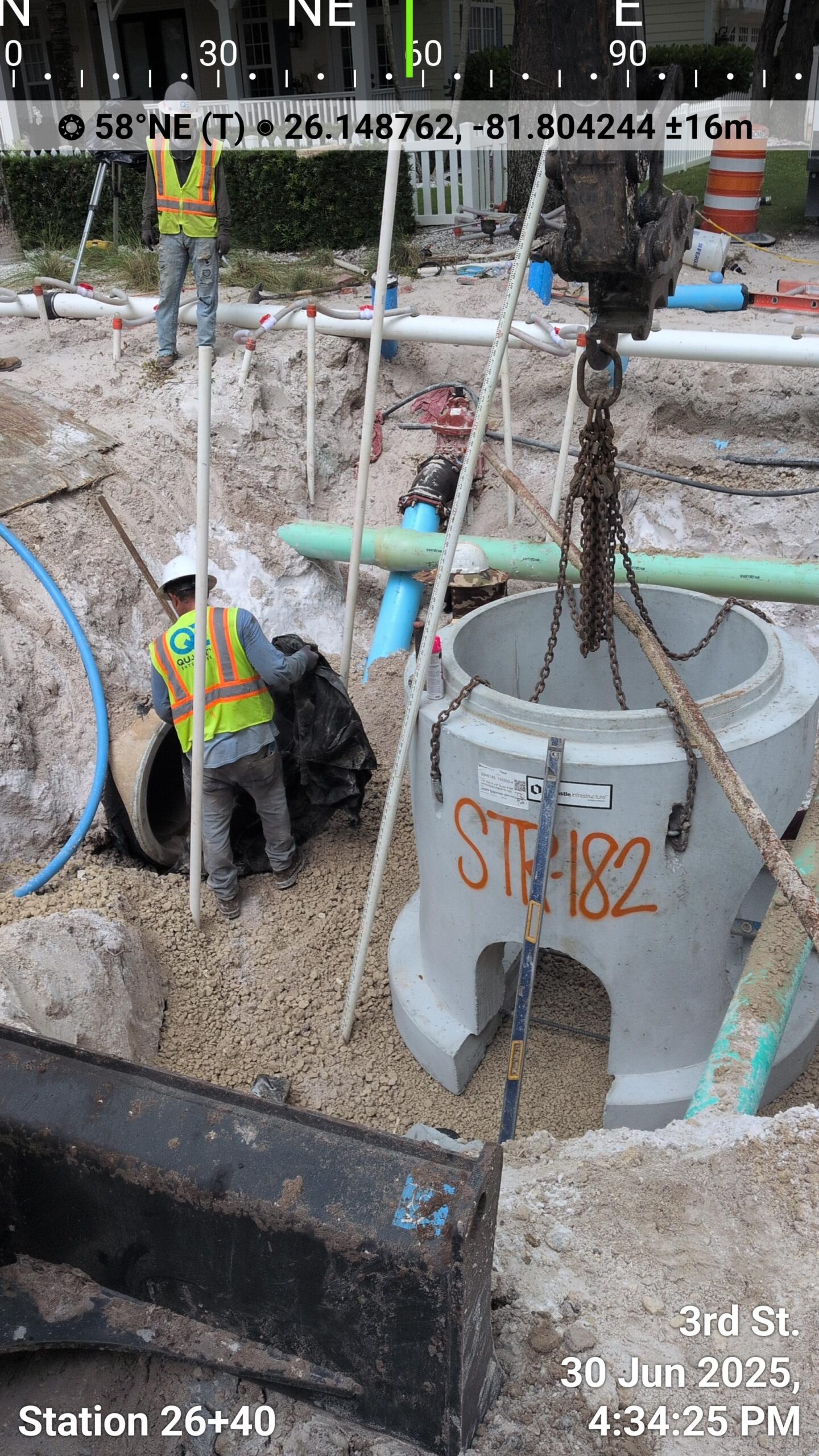

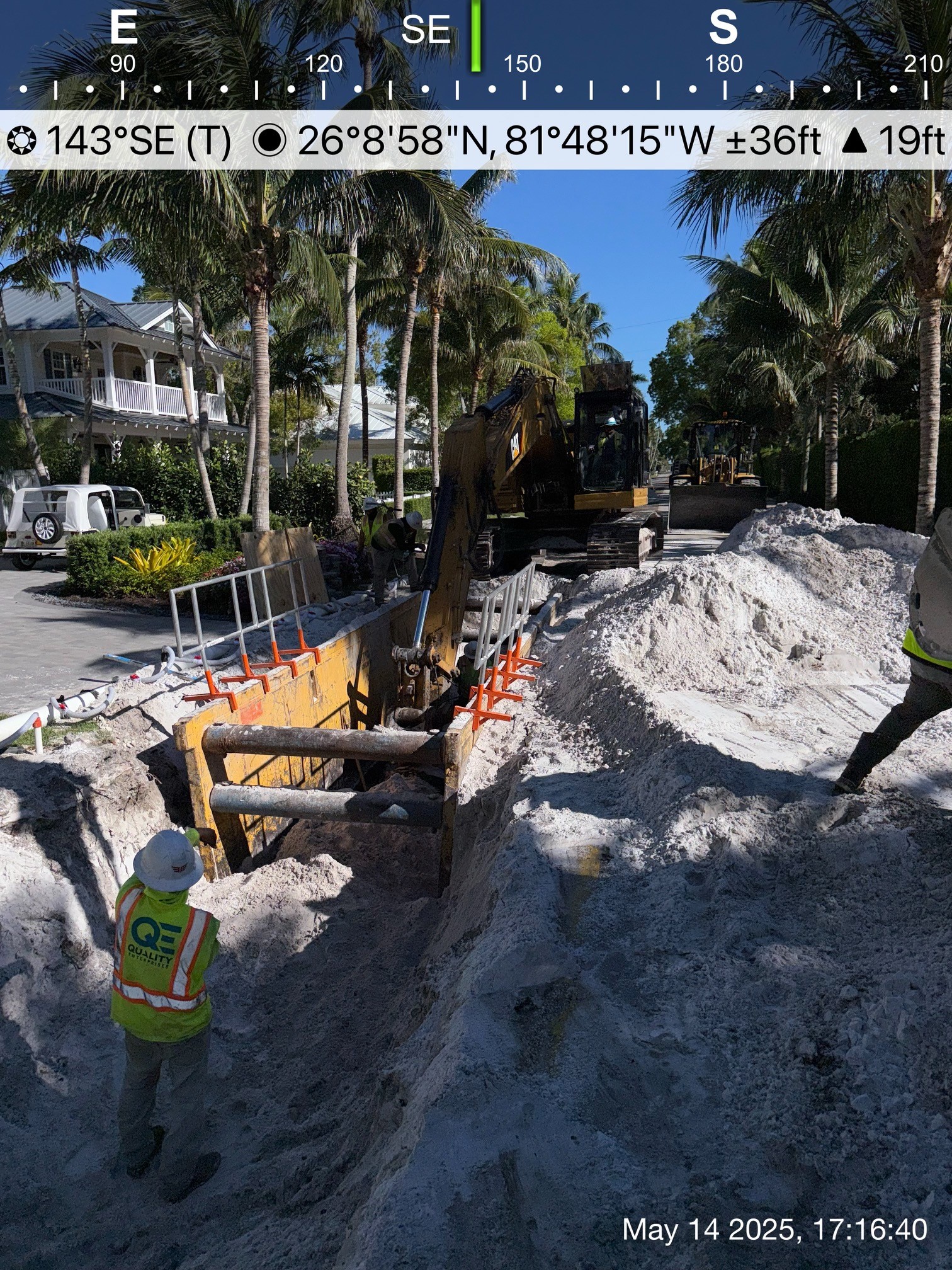

- The storm drainage and watermain infrastructure is substantially complete between 4th Avenue North and 1st Avenue North.
- Construction has advanced into the final roadway, drainage, and watermain phase between 1st Avenue North and 2nd Avenue South, which is anticipated to be substantially complete by the end of 2026.
- The watermain installation between 1st Avenue North and 1st Avenue South is nearly complete. Storm drainage will be installed following the watermain work.
Offshore Outfall Installation
- A major project milestone was achieved in April with the successful completion and testing of horizontal directional drilling (HDD) for the two 36-inch fused HDPE offshore outfall pipes extending into the Gulf. Completion of this work also eliminates conflicts with sea turtle nesting season restrictions on beach activities.
- The HDD crew completed installation of the offshore diffusers for both pump stations in August 2026. Completion of the offshore work aligns with pump station progress and supports the start of South Pump Station testing in September 2026.

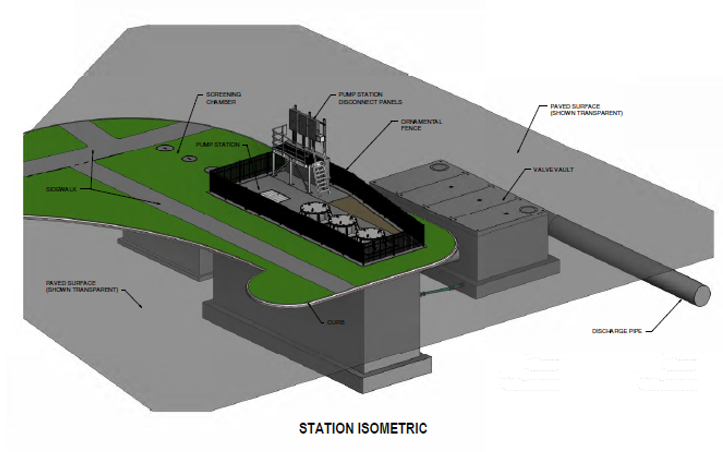

South Pump Station
- Construction of the South Pump Station is approximately 95 percent complete.
- Kiewit’s electrical subcontractor began installing controls equipment in May. The startup began in September 2026, with testing continuing through November 2026.
- The south basin stormwater system is now fully connected from Alligator Lake to the South Pump Station and will begin operating as intended as pump station testing continues.
Alligator Lake
- Landscaping improvements at Alligator Lake were completed in May.
- Construction of the maintenance paver drive is being installed in October.
- The pinch valve that controls flow from Alligator Lake to the South Pump Station was installed in early September 2026. Roadway restoration for the box culvert that crosses GSBN at Alligator Lake will be completed in October 2026.

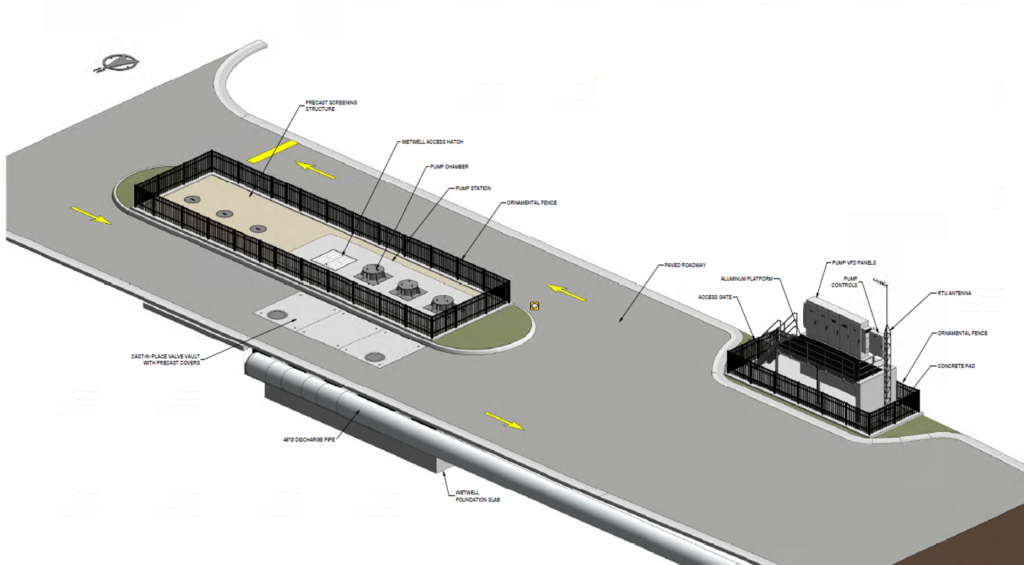

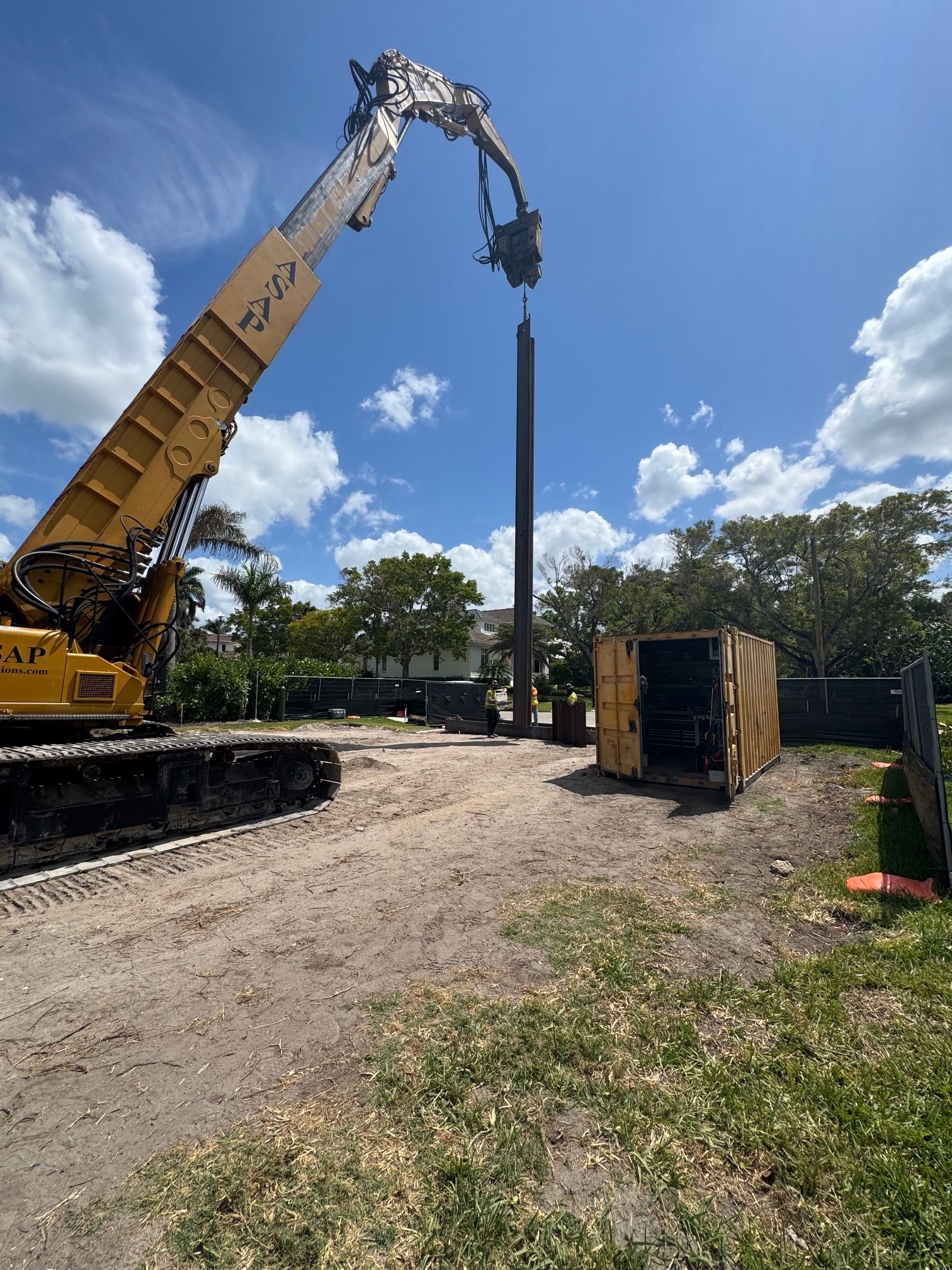

North Pump Station
- Construction of the North Pump Station is approximately 80 percent complete.
- Electrical and controls equipment installation is scheduled to begin in December 2026 and continue through January 2027, with North Pump Station commissioning to follow in early 2027.
Project Schedule
- Construction continues to outperform the original baseline schedule across multiple components of the project.
- 3rd Street improvements and North Basin G Structures are 100 percent complete, finishing three months and seven months ahead of schedule, respectively.
- Gulfshore Boulevard N. roadway, drainage, and watermain work is approximately 80 percent complete and two months ahead of schedule. The South Pump Station is approximately 95 percent complete and three months ahead of schedule, while the North Pump Station is approximately 80 percent complete and two months ahead of schedule.
- NPS Horizontal Directional Drilling and Offshore Diffuser Installation are both 100 percent complete and on time.
- The project’s contractual completion date remains June 4, 2027. Based on current progress, Kiewit’s estimated final completion date remains May 2027, and Kiewit remains optimistic that continued progress may allow final completion to be advanced earlier in 2027.
Overall Construction Progress
Current installation totals include:
- Storm drainage: 6,800 of 9,600 linear feet installed (71%)
- Watermain: 5,200 of 6,100 linear feet installed (85%)
- Inlet and manhole structures: 80 of 113 installed (71%)
- 36-inch HDPE offshore outfall pipe: 3,200 of 3,200 linear feet installed (100%)
Construction percentages and schedule milestones are approximate and measured against the project’s baseline schedule.
8th Ave. N. Pump Station
Crews are actively working on the 8th Avenue North pump station. Access to the beach from 8th Avenue North will be closed until summer 2026.
3rd Ave. N. Pump Station
Crews are actively working on the 3rd Avenue North pump station. Access to the beach from 3rd Avenue North will be closed until summer 2026.
